Outage of a 50MW Concentrated Solar Plant

Customer:

ContourGlobal

Location:

Spain

The Netherlands
Markets:
Energy TransitionEnergy
Scope:

We performed an overhaul of a 50MW steam turbine generator at a concentrated solar plant in Spain. The complete overhaul was executed under tight COVID-19 restrictions, and delivered 4 days ahead of the planned schedule.


Fast facts
ProjectMajor Overhaul Steam Turbine Generator 50MW
ClientContourGlobal

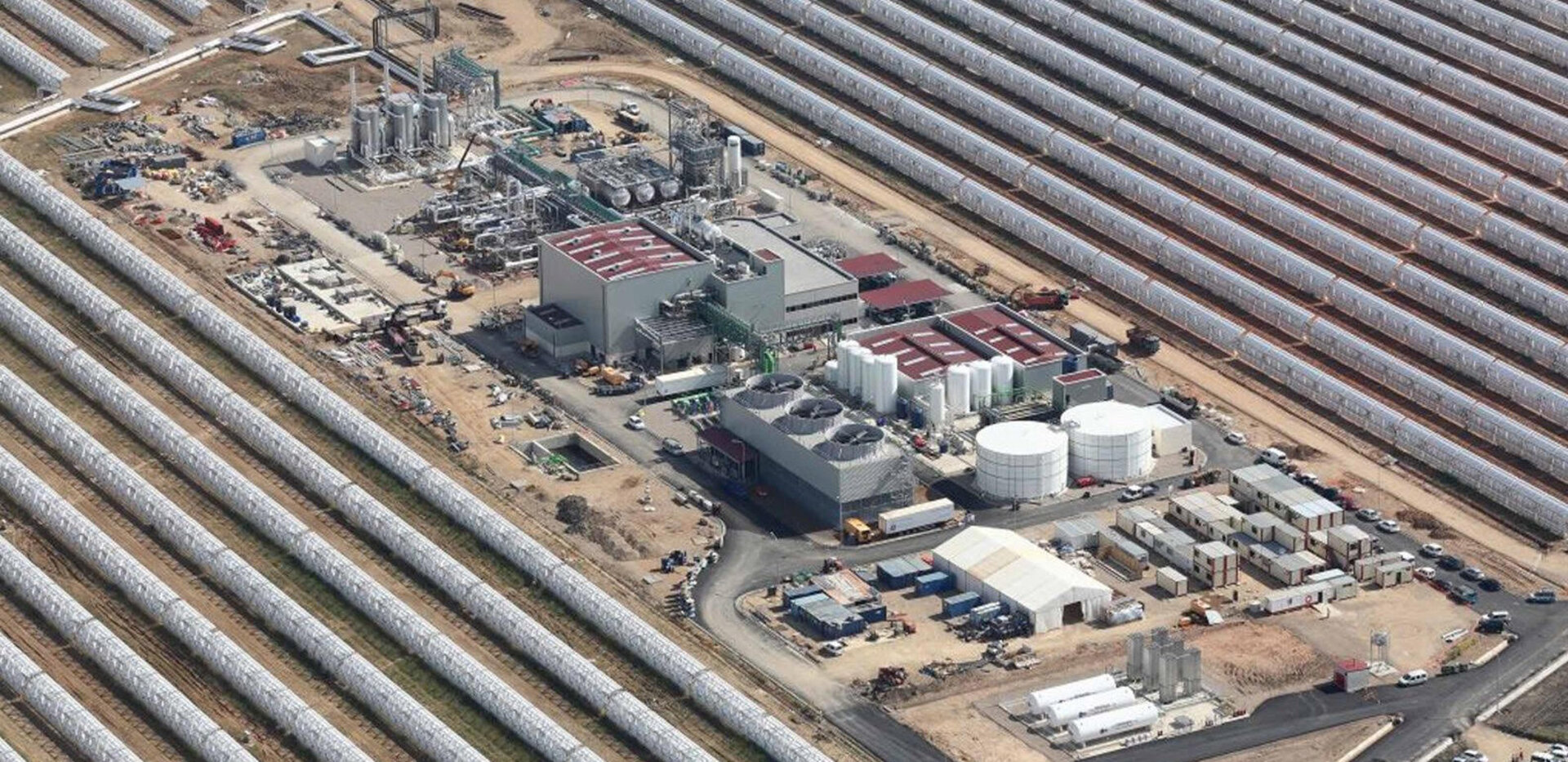

Name of facilityPalma 1
Type of facilityThermal Solar Power
IndustrySolar
OEMNuevo Pignone
Site locationPalma del Rio, Spain
DurationOutage 6 weeks, preparation 3 months
RoleMain contractor
Contract typeLumpsum (full-scope major overhaul)



Services:
SustainabilityTurnaround

We partnered with the client from start to end. As the main contractor we were responsible for full outage preparation, execution and commissioning, implementing our proven outage project approach. Our risk-based approach enabled the team to proactively steer on risks and implement mitigating actions.

We delivered the following services:

  • Commissioning & technical consultancy
  • Turnaround/Outage Management (turnkey)
  • Commissioning & technical consultancy
  • Major Overhaul LP & HP turbines incl. valves
  • Disassembly and assembly of all equipment
  • Inspection of Generator
  • Inspection of Gearbox
  • Electrical & Instrumentation
  • Reverse engineering & fabrication of spare parts
  • On-site balancing
  • Logistics



Client benefits

  • Safe and high-quality delivery
  • Single point of contact for complete outage scope
  • Project delivered 4 days ahead of planned schedule
